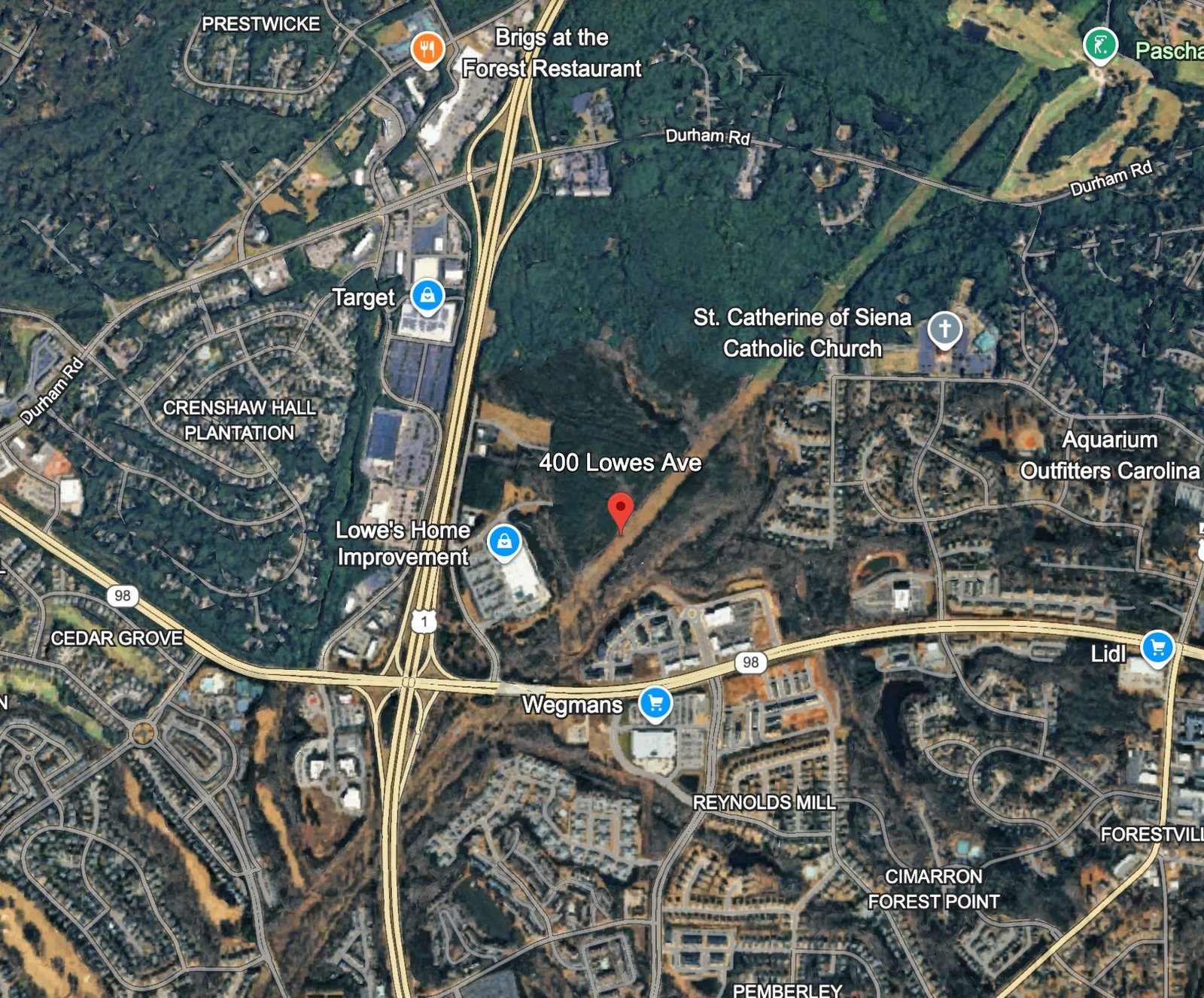

A wider perspective of the Northern Wake Forest commercial hub. The site (center right) is shown relative to high-volume retailers like Wegmans and Samâs Club, highlighting the density of the existing corridor.
Correction and Apology
In a previous article regarding the âGrovedaleâ project, I speculated that the developer, Alliance Group NC (AGNC), was âover-extended.â That characterization was incorrect, and I sincerely apologize to Alliance Group NC. The following update focuses strictly on the procedural status of the application and the infrastructure projects outlined in the Townâs public documents.
For the last year, many Wake Forest residents have been tracking the âGrovedaleâ projectâa large commercial development on Ligon Mill Road that matched the specifications of a Costco Wholesale.
Sattelite Imagery of Location Ligon Mill on the east side, which isnât completed, Richland Creek serves as a major hurdle to accessing the site from 98. The bridge must be built before the location can be adequate for the type of traffic.
If the deal isnât dead, what is the hold-up? A close examination of the Townâs draft Capital Improvement Plan (CIP)map and local satellite imagery reveals a massive engineering challenge.
The proposed site (located at 400 Lowes Ave) is effectively landlocked. To make a high-volume retail site viable here, you need more than a driveway; you need a bridge.
The Town has identified this specific need. On the CIP map, it is designated as Project GTP-4: a roadway project extending Ligon Mill Road north, bridging over Richland Creek, and connecting directly to the Hwy 98 Bypass.

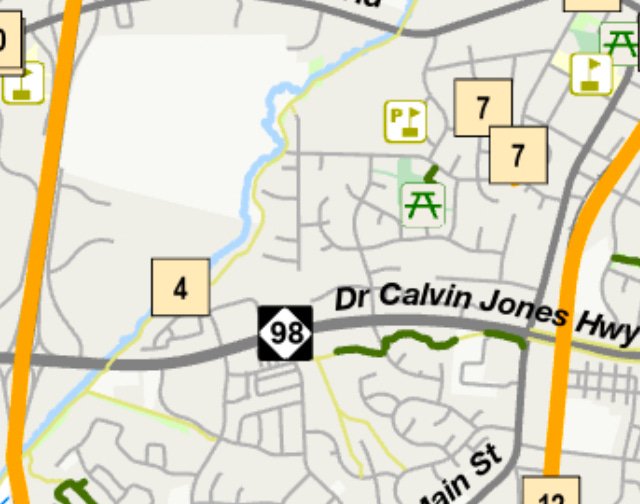

Screenshot from Town of Wake Forest CIP Map showing GTP-4 project location over Richland Creek.
Why this bridge is the dealbreaker:
The âMoatâ: Satellite imagery confirms that Richland Creek runs along the western edge of the property, separating the site from the existing Loweâs. This creates a natural barrier that requires a heavy-duty bridge capable of handling freight trucks and thousands of cars daily.
The Budget Gap: The Townâs current CIP proposal does not schedule funding for Project GTP-4 until 2028.
The Cost: Bridges are expensive. Estimates for a project of this magnitude could easily exceed $8 million.
This creates a substantial gap. The developer needs the bridge now to open the store. The Town isnât scheduled to pay for it for another three years. This multi-million dollar âgapâ is likely the subject of the âsensitiveâ quiet conversations currently happening at Town Hall.
Topography and Constraints
Beyond the bridge, the maps reveal why this site is so complex (and expensive) to develop.
Environmental Buffers: Because the site borders Richland Creek, state and local regulations likely enforce strict âimpervious surfaceâ buffers. This means the developer cannot pave right up to the waterâs edge, forcing them to squeeze a massive warehouse and parking lot into a smaller buildable footprint.
Grading Costs: A comparison of the satellite view shows the site is currently a dense forest with uneven terrain, contrasting sharply with the flat, paved plateau of the neighboring Loweâs. To build here, the developer must clear the land and perform significant earthwork to create a level 150,000+ square foot pad. This is not a âplug-and-playâ site; it is a major engineering project.
What We Are Watching
Currently, the project is in a quiet period. There are no active applications to review, and the discussions are likely private.
However, there is one upcoming public event that may offer a clue: The Public Hearing on the Capital Improvement Plan.
When: Tuesday, December 16th, 6:00PM
Where: Wake Forest Town Hall, 301 Brooks St, Wake Forest, NC 27587
What to look for: Any discussion regarding Project GTP-4 (Ligon Mill Road Extension).
If the Town Board moves the funding for the bridge up in the schedule, it would be a strong signal that they are paving the way for the development to proceed. If the funding remains slated for 2028, it suggests that the âgapâ has not yet been closed.
For now, the project sits in the darkânot necessarily gone, but waiting for the infrastructure numbers to align.
Do you have a question about a development sign youâve seen around town? Email us at WakeForestMatters@pm.me
